Complete Guide to Equipment Selection & Technical Specifications for Continuous Concrete Batching Plant

Release Time: 2025-12-25

Introduction

Selecting the right continuous concrete batching plant is one of the most critical decisions for construction companies, precast manufacturers, and concrete producers. This comprehensive technical guide addresses the needs of procurement teams, engineers, and project managers who are evaluating equipment options to meet their specific operational requirements. With production capacity ranging from 8 m³/hour for mini batch plants to over 200 m³/hour for large stationary installations, understanding the technical specifications and selection criteria is essential for making informed decisions that will impact your project's efficiency, quality, and profitability.

The equipment selection process extends far beyond capacity considerations. It encompasses mixer types, automation capabilities, cement storage solutions, aggregate batching systems, control technology, manufacturer reliability, and comprehensive after-sales support. This guide provides detailed technical insights to help you navigate through these critical factors and select a continuous concrete batching plant that aligns perfectly with your operational needs.

Understanding Production Capacity Requirements

Defining Your Production Needs

The foundation of any equipment selection process begins with a clear understanding of your production requirements. Production capacity directly influences the size, cost, and operational scope of your continuous concrete batching plant installation.

Mini Batch Plants produce between 8-13 m³/hour, making them ideal for small residential projects, repair work, and situations where space constraints limit equipment size. These compact installations require minimal foundation preparation and can be set up quickly on site.

Portable Concrete Plants deliver 10-30 m³/hour output, suitable for medium-scale projects with moderate concrete demands. Their compact design and integrated components allow for relatively quick relocation between job sites while maintaining good production efficiency.

Mobile Concrete Plants operate in the 20-60 m³/hour capacity range and are designed for temporary installations requiring frequent site-to-site relocation. These units come pre-wired and pre-assembled, significantly reducing installation time compared to stationary systems.

Stationary Concrete Plants represent the largest category with production capacities ranging from 30 to 200 m³/hour or higher. These permanent installations are engineered for large-scale, long-term projects requiring consistent, high-volume concrete production.

When determining your capacity requirements, consider these critical factors:

  • Daily concrete consumption based on project schedule and construction methodology

  • Peak demand periods and average production requirements

  • Future expansion potential and anticipated project growth

  • Supply frequency needs and on-site storage limitations

  • Multiple site operations and whether equipment relocation is necessary

Many contractors underestimate capacity needs initially, resulting in production bottlenecks. Conversely, oversized installations lead to unnecessary capital expenditure and operational inefficiency. The optimal selection requires balancing current project demands with realistic growth projections.

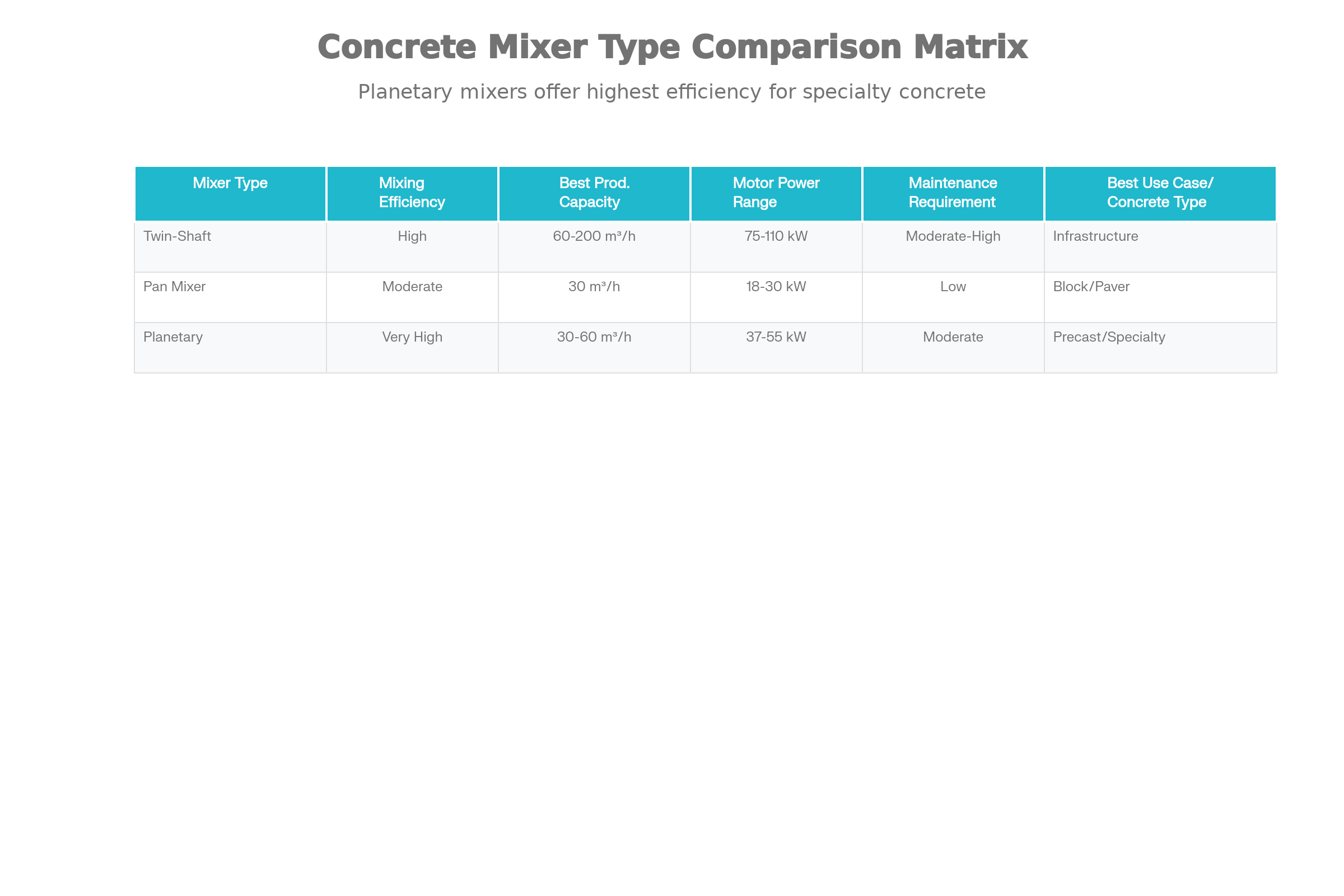

Concrete Mixer Types and Technical Specifications

Twin-Shaft Concrete Mixers

Twin-shaft mixers represent the industry standard for large-scale continuous concrete production, particularly for ready-mix concrete, roller-compacted concrete (RCC), and high-performance applications. These mixers employ two synchronized horizontal shafts rotating in opposite directions, ensuring rapid and homogeneous mixing of all concrete components.

Technical Specifications of Twin-Shaft Mixers:

CapacityInternal VolumeWet Concrete OutputMotor PowerWear Plate Thickness
60 m³/h1500 L1000 L2 × 18.5 kW25mm base, 15mm side
90 m³/h1500 L1500 L2 × 22 kW25mm base, 15mm side
120 m³/h2250 L2000 L2 × 37 kW30mm base, 20mm side
180 m³/h3000 L3000 L2 × 45 kW30mm base, 20mm side

Key Advantages:

  • Superior mixing efficiency with synchronized dual-shaft mechanism delivering uniform concrete distribution

  • Fast mixing cycles typically 60-72 seconds, maximizing production throughput

  • Heavy-duty construction with wear-resistant Ni-Hard cast components ensuring extended service life

  • Automatic lubrication systems with programmable digital displays reducing maintenance interventions

  • Multiple motor capacity options optimizing power consumption for different production scales

  • Replaceable wear components that extend mixer longevity while maintaining concrete quality

The twin-shaft design excels at mixing large aggregate sizes up to 80-100mm, making it ideal for infrastructure projects, dam construction, and mass concrete applications. The synchronized shafts prevent material segregation and ensure consistent concrete strength across all batches.

Pan Mixers

Pan mixers utilize a rotating pan base with fixed mixing arms, providing a different mixing mechanism particularly suited for precast concrete, block manufacturing, and paving applications. These mixers are known for their compact footprint and efficient mixing action suitable for lower to medium production volumes.

Technical Specifications of Pan Mixers:
CapacityInternal VolumeWet Concrete OutputMotor PowerAggregate SizeBest Applications
30 m³/h750 L500 L22 kW80/60mmPrecast, Blocks

Pan mixers feature a robust six-arm mixing system that ensures even aggregate distribution throughout the concrete mass. The adjustable discharge gates provide controlled concrete flow, preventing spillage and material loss during transfer. Heavy-duty wear plates constructed from 15mm Hardox base material with 10mm sides withstand continuous operation in demanding production environments.

The pan mixer's design proves particularly effective for producing colored concrete, specialty finishes, and precast elements where precise control over mixing time and consistency is paramount. The compact design makes these units suitable for precast plants operating in space-constrained environments.

Planetary Mixers

Planetary mixers represent the premium solution for high-quality precast concrete, ultra-high-performance concrete (UHPC), and architectural applications requiring superior consistency and uniform mixing. The planetary motion mechanism, combining vertical and rotational mixing movements, ensures complete blending of all concrete components.

Technical Specifications of Planetary Mixers:

CapacityInternal VolumeWet Concrete OutputMotor PowerReducerBest For
30 m³/h750 L500 L18.5 kWBrevini PlanetaryPrecast Elements
60 m³/h1500 L1000 L45 kWBrevini PlanetaryUHPC, Specialty

Planetary mixers employ multiple mixing tools including three mixing feet and one scraper blade, optimizing performance across different mix designs and aggregate sizes. These units are equipped with high-performance Brevini planetary reducers, ensuring smooth operation and minimal maintenance requirements. The wear-resistant Ni-Hard cast components maintain their precision over extended operational periods.

Production Capacity and Performance Metrics

Matching Capacity to Project Requirements

Proper capacity selection requires detailed analysis of concrete consumption patterns and project timelines. Consider the following framework:

Small to Medium Projects (Daily Consumption 200-400 m³)
  • Recommended Plant Capacity: 30-60 m³/hour

  • Typical Installation: Mobile or Portable Systems

  • Project Duration: 3-12 months

  • Suitable for: Commercial buildings, residential complexes, small infrastructure

Large Infrastructure Projects (Daily Consumption 500-1,000+ m³)

  • Recommended Plant Capacity: 90-180 m³/hour

  • Typical Installation: Stationary Systems

  • Project Duration: 12+ months

  • Suitable for: Major highways, dams, bridges, substantial precast operations

The relationship between daily consumption and plant capacity should incorporate production efficiency factors including mixing cycles, material handling time, and quality control intervals. A plant operating at 90% capacity typically delivers optimal performance, while sustained operation above 95% capacity risks equipment stress and maintenance complications.

Cycle Time Calculations:

Continuous concrete batching plants operate on defined cycle times—the duration required to batch, mix, and discharge one concrete load. Standard cycle times for properly maintained equipment range from 60-75 seconds. This means a 60 m³/h plant theoretically completes approximately 60 batches per hour (3,600 seconds ÷ 60-second cycle time = 60 batches).

Practical production typically achieves 85-90% of theoretical capacity due to quality control procedures, material changeovers, and scheduled maintenance. Therefore, when planning procurement for a 60 m³/h requirement, selecting equipment rated for 70 m³/h provides the necessary operational headroom.

Aggregate Batching Systems and Specifications

Technical Specifications of Aggregate Batching Equipment

Aggregate batching accuracy directly impacts concrete quality and consistency. Modern continuous batching plants employ high-precision weighing systems with accuracy tolerances of ±2% for aggregates and ±1% for cement.

Standard Aggregate Batching System Specifications:

ModelWeighing Hopper VolumeStorage CapacityProduction CapacityWeighing AccuracyMax WeightAggregate Categories
AG8000.8 m³2×2 m³48 m³/h±2%1,500 kg2 types
AG1200-31.2 m³4×2.2 m³60 m³/h±2%2,000 kg4 types
AG1600-21.6 m³4×3.7 m³80 m³/h±2%3,000 kg4 types
AG24002.4 m³3×12 m³120 m³/h±2%4,000 kg3 types
AG32003.2 m³3×20 m³160 m³/h±2%5,000 kg3 types

Aggregate batching systems feature multiple hoppers that store different aggregate types (fine sand, coarse aggregates, specialty materials) separately. High-precision load cell sensors mounted beneath each hopper bin continuously monitor material weight, feeding this data to the control system for real-time adjustment. The system employs pneumatic door gates or belt conveyors for controlled material discharge, ensuring accurate portioning within acceptable tolerances.

The number of aggregate categories your plant can handle influences the versatility of concrete mix designs. Plants handling 3-4 aggregate types provide flexibility for standard concrete mixes, while systems managing 5-6+ types accommodate specialized applications including colored concrete, decorative finishes, and high-performance mixes.

Cement Storage and Delivery Systems

Cement Silo Specifications and Capacity Options

Cement storage represents a critical infrastructure component for uninterrupted concrete production. Modern cement silos provide sealed storage preventing moisture ingress and dust contamination while enabling efficient material conveyance to the mixing system.

Cement Silo Capacity and Technical Specifications:
Silo CapacityDiameterNumber of LayersWall ThicknessLeg DistanceVolume (M³)
50T3,200mm33-5mm2,108mm40.77
100T3,200mm63-4-5mm2,108mm78.46
150T3,800mm63-4-5mm2,547mm113.08
200T4,500mm63-4-5-6mm3,001mm160
300T5,000mm74-5-6mm3,208mm220
400T5,700mm74-5-6-8mm2,670mm300.77

Silo Selection Criteria:

  • Production Continuity: Calculate silo capacity based on daily cement consumption and restock frequency. A 200T silo supporting a 60 m³/h plant (consuming approximately 300-350 kg/m³) provides 2-3 days of continuous operation

  • Supply Schedule: Coordinate silo capacity with cement delivery frequency; align capacity with supplier schedules and transportation constraints

  • Space Requirements: Larger silos require proportionally greater footprint; assess available site space including clearance for truck access and material delivery

  • Maintenance Access: Ensure adequate space around silos for internal cleaning, valve maintenance, and equipment servicing

Modern cement silos incorporate intelligent material-level sensing systems detecting cement height through electronic sensors, triggering refill alerts when inventory reaches predetermined thresholds. This automation prevents production interruptions due to cement depletion while optimizing inventory management.

Dust collection systems installed at silo tops capture airborne cement particles during loading operations, reducing environmental emissions and material losses. These systems employ vibrating mechanisms that automatically clear accumulated dust, maintaining system efficiency throughout extended operational periods.

Automation and Control Systems

Programmable Logic Controllers (PLC) and SCADA Integration

Modern continuous concrete batching plants leverage advanced automation technology through Programmable Logic Controllers (PLC) systems integrated with Supervisory Control and Data Acquisition (SCADA) platforms. These systems function complementarily—the PLC executes precise control logic for batching, mixing, and transfer operations, while the SCADA system provides visual monitoring interfaces and operator controls.

Key Automation System Capabilities:

Real-Time Monitoring and Process Control
  • Continuous sensor data collection from aggregate weighing systems, mixer load cells, cement conveyors, and water distribution systems

  • Real-time adjustment of operation parameters maintaining target concrete specifications

  • Simultaneous operation of multiple equipment systems with coordinated sequencing

  • Automatic safety interlocks preventing equipment operation when conditions fall outside safe parameters

Data Logging and Performance Reporting

  • Comprehensive production records documenting each concrete batch, ingredients, mixing times, and quality parameters

  • Historical data analysis identifying production trends, equipment performance, and efficiency metrics

  • Official receipt generation for customer documentation and quality assurance

  • Predictive maintenance alerts based on equipment operating hours and performance trends

Remote Accessibility and Troubleshooting

  • Remote monitoring capability enabling operators and technical support staff to observe plant operation from mobile devices or external locations

  • Diagnostic data transmission facilitating rapid troubleshooting with manufacturer support teams

  • Over-the-air software updates implementing system improvements and feature enhancements

  • Reduced downtime through expedited problem identification and resolution

Energy Optimization

  • Smart power management systems continuously monitoring energy consumption across all plant components

  • Automated motor speed adjustments reducing unnecessary power draw during partial-load operations

  • Scheduled maintenance alerts preventing equipment inefficiency due to component wear or system degradation

  • Energy efficiency reporting supporting operational cost reduction initiatives

Safety Integration

  • Automated safety protocols limiting direct human involvement in hazardous operations

  • Emergency stop mechanisms functioning independently from primary control systems

  • Personnel proximity detection preventing equipment operation in occupied areas

  • Compliance documentation supporting workplace safety certifications

Mobile vs. Stationary Installation Options

Comprehensive Comparison Framework

The choice between mobile and stationary continuous concrete batching plant configurations significantly impacts project flexibility, operational costs, and production capabilities. This comparison examines critical decision factors across multiple operational dimensions.

Installation Time and Site Preparation:

Mobile Concrete Plants typically require 3-5 days for complete setup including equipment positioning, utility connections, and system calibration. These units arrive pre-assembled and pre-wired, requiring only basic leveling and power connections. Site preparation involves minimal concrete foundation work, reducing infrastructure costs and timeline delays.

Stationary Concrete Plants typically require 2-4 weeks for comprehensive installation including site preparation, foundation construction, equipment assembly, and system integration. The larger installation footprint and interconnected component systems necessitate careful coordination and extended commissioning procedures. However, the permanent installation provides superior stability and operational reliability for long-duration projects.

Mobility and Operational Flexibility:

Mobile plants excel when project requirements necessitate site relocation, whether due to multiple construction locations or temporary project status. The integrated design reduces disassembly time to 2-3 days, enabling rapid transitions between job sites. This flexibility supports contract production operations serving multiple customers across geographically dispersed locations.

Stationary plants remain fixed at single locations, providing strategic advantages for centralized production supporting large infrastructure projects, precast facilities, or long-term supply contracts. Once established, stationary systems deliver consistent production without relocation disruptions.

Production Capacity Considerations:

Mobile concrete batching plants typically deliver capacities between 20-60 m³/hour, optimized for temporary installations and projects requiring moderate to substantial concrete volumes. While highly efficient, mobile units sacrifice raw capacity for portability.

Stationary systems accommodate production capacities from 30 to 200+ m³/hour, enabling high-volume production operations supporting major infrastructure and precast manufacturing. The larger capacity enables serving multiple concurrent projects from single installations.

Comparative Analysis Table:
Operational FactorMobile PlantsStationary Plants
Installation Time3-5 days2-4 weeks
Setup Space RequiredMinimal (flat surface)Substantial (foundation/utilities)
Foundation RequirementsNone/minimalSubstantial (concrete pads)
Production Capacity Range20-60 m³/h30-200+ m³/h
Relocation Time2-3 daysNot relocatable
Flexibility for Multiple SitesExcellentLimited
Long-term Project EconomicsHigher cost/m³Lower cost/m³
Quality ConsistencyHighHigh
Maintenance AccessGoodExcellent
Capital InvestmentLower initialHigher initial
Operational Lifespan8-12 years15-20+ years

Material Quality and Manufacturing Standards

Equipment Durability and Wear Part Selection

Wear components subjected to continuous abrasive concrete contact directly impact plant longevity and maintenance costs. Selecting equipment featuring premium wear-resistant materials significantly reduces replacement frequency and operational interruptions.

Wear Component Material Specifications:

Mixer Wear Plates
  • Ni-Hard Cast Material: Superior hardness resisting aggregate abrasion throughout extended service periods; provides 2-3x longevity compared to standard steel

  • Thickness Specifications: 25-30mm base plates with 15-20mm side plates accommodating aggressive mixing action

  • Replacement Indicators: Color-coding or measurement systems tracking wear progression, alerting operators when replacement becomes necessary

Aggregate Hopper Liners

  • Hardened Steel Construction: Resists impact and abrasion from continuous aggregate discharge

  • Replacement Frequency: Typically 18-24 months depending on material type and production intensity

Conveyor Belts and Pulleys

  • Industrial-Grade Materials: Constructed from reinforced rubber with embedded steel cables ensuring durability and load-bearing capacity

  • Tension Monitoring: Automatic adjustment systems maintaining optimal belt tension throughout operational periods

Cement Silo Components

  • Corrosion-Resistant Coatings: Protect metallic surfaces from moisture and chemical deterioration

  • Sealed Connections: Prevent moisture ingress that would compromise cement quality

Procuring equipment from manufacturers emphasizing wear-resistant component selection reduces long-term operating costs through extended component life and reduced maintenance interventions.

Weighing Accuracy and Quality Control

Precision Measurement Systems

Concrete quality fundamentally depends on precise ingredient portioning. Modern continuous concrete batching plants employ sophisticated weighing systems ensuring consistent concrete properties batch after batch.

Weighing System Specifications:

Aggregate Weighing Accuracy
  • Tolerance Standard: ±2% across all aggregate categories

  • Load Cell Technology: Multiple load cells beneath each hopper bin providing redundant measurement and sensor failure detection

  • Calibration Protocol: Monthly calibration against certified standards ensuring sustained accuracy

  • Real-time Adjustment: Automatic gate positioning based on actual vs. target weights within measurement cycles

Cement Weighing Accuracy

  • Tolerance Standard: ±1% ensuring precise cement proportioning

  • Specialized Load Cells: High-sensitivity sensors accommodating cement's lower density compared to aggregates

  • Dust Consideration: System compensation accounting for dust settlement during measurement cycles

Water Proportioning

  • Flow Meter Technology: Precision measurement of water addition to achieve target water-cement ratios

  • Temperature Compensation: Automatic adjustment for temperature effects on water density

Maintaining these accuracy tolerances demands regular maintenance including load cell calibration, software verification, and sensor cleaning. Dust accumulation on load cell sensing surfaces introduces measurement errors; weekly inspection and cleaning of sensor areas prevents accuracy drift.

Key Selection Criteria for Engineers and Procurement Teams

Systematic Evaluation Framework

Selecting the optimal continuous concrete batching plant requires systematic evaluation across technical, operational, financial, and support dimensions. This framework guides engineers and procurement teams through comprehensive assessment:

  1. Production Requirement Analysis

  • Calculate daily concrete consumption considering project schedule, construction methodology, and peak demand periods

  • Determine required plant capacity incorporating 10-15% operational headroom

  • Project timeline influences equipment configuration—short-term projects favor mobile solutions, long-term operations justify stationary investments

  • Assess future expansion potential and whether current equipment selection accommodates anticipated growth

  1. Technical Specification Validation

  • Confirm mixer type selection matches concrete type requirements (ready-mix requires twin-shaft efficiency; specialty work may justify planetary accuracy)

  • Verify cement storage capacity aligns with consumption rates and supply logistics

  • Validate aggregate batching system accommodates all required concrete mix designs

  • Assess automation integration requirements and control system complexity

  1. Reliability and Quality Assurance

  • Review manufacturer quality certifications (ISO standards, CE compliance)

  • Evaluate equipment durability through warranty terms and expected operational lifespan

  • Assess wear part quality and component replacement frequency

  • Consider manufacturer reputation, industry references, and customer satisfaction ratings

  1. Installation and Operational Considerations

  • Evaluate site space requirements, foundation specifications, and utility connections

  • Assess installation timeline impacts on project scheduling

  • Consider equipment accessibility for maintenance and component replacement

  • Review operator training requirements and support documentation

  1. Financial Analysis

  • Compare total cost of ownership including capital investment, installation, operational expenses, maintenance, and wear parts

  • Calculate cost per cubic meter of concrete produced

  • Model payback period and return on investment

  • Consider financing options and equipment leasing alternatives

  1. Manufacturer and Support Evaluation

  • Verify spare parts availability and standard delivery timelines

  • Confirm technical support accessibility, response times, and service quality

  • Assess training program comprehensiveness and documentation quality

  • Review warranty coverage and optional extended service agreements

  • Evaluate after-sales service network proximity and support capabilities

Manufacturer and After-Sales Support Considerations

Critical Service Infrastructure

Equipment selection should extend beyond technical specifications to encompass comprehensive after-sales support ensuring optimal equipment performance throughout its operational lifespan. Established manufacturers prioritize customer support as core business function.

Leading Manufacturers in the Industry:

Top manufacturers including ASTEC Industries, Stephens Manufacturing, Vince Hagan Company, MEKA Global, and Semix Global distinguish themselves through comprehensive service networks, spare parts availability, and technical expertise. These organizations operate global service operations with regional support centers enabling rapid response to equipment issues and maintenance requirements.

After-Sales Service Components:

Professional Installation and Commissioning
  • Turnkey plant setup including equipment positioning, utility connections, and system calibration

  • On-site operator training ensuring personnel proficiency with plant operations and maintenance protocols

  • Comprehensive system testing validating equipment functionality before production initiation

Continuous Technical Support

  • 24/7 technical support lines connecting operators with experienced technicians for rapid problem-solving

  • Remote diagnostic capabilities enabling manufacturers to identify issues without on-site visits

  • Online knowledge bases and documentation resources supporting operator self-troubleshooting

Spare Parts Management

  • Extensive spare parts inventory ensuring rapid availability of replacement components

  • Overnight or next-day delivery options for critical components minimizing production downtime

  • Genuine parts certification guaranteeing compatibility and performance

Planned Maintenance Services

  • Scheduled preventive maintenance programs extending equipment operational lifespan

  • Expert lubrication and calibration services optimizing equipment efficiency

  • Wear component monitoring and proactive replacement recommendations

Extended Service Agreements

  • Comprehensive maintenance packages covering labor, parts, and routine service

  • Performance-based agreements guaranteeing uptime percentages and rapid response times

  • Training program extensions keeping operators current with equipment upgrades and procedural changes

For additional technical resources and information on wear parts and maintenance components, professional suppliers like https://www.htwearparts.com/ provide extensive product catalogs and technical support services.

Maintenance Requirements and Reliability Planning

Preventive Maintenance Framework

Regular maintenance schedules directly impact equipment longevity and operational reliability. Organizations should implement systematic maintenance protocols addressing daily, weekly, monthly, and long-term service requirements.

Daily Maintenance Tasks
  • Visual inspection of structural components for wear, cracks, or damage

  • Safety device verification ensuring emergency stops and guards function correctly

  • Belt and chain inspection for tension, wear, and proper alignment

Weekly Maintenance Tasks

  • Fluid level checks for hydraulic systems and cooling circuits

  • Fastener verification ensuring all bolts and nuts remain secure

  • Electrical system inspection checking for corrosion and loose connections

Monthly Maintenance Tasks

  • Detailed wear component assessment identifying components requiring replacement

  • Bearing lubrication following manufacturer specifications

  • Structural integrity examination detecting rust or stress damage

Long-Term Maintenance Planning

  • Major equipment overhauls every 1-2 years involving comprehensive disassembly and component inspection

  • Detailed maintenance logging tracking all service activities and identifying recurring issues

  • Spare parts inventory management ensuring critical components remain readily available

Cost-Benefit Analysis Framework

Total Cost of Ownership Model

While initial capital investment captures attention, comprehensive cost-benefit analysis should consider total cost of ownership across the equipment's operational lifespan.

Cost Components Analysis:

Capital Investment: Equipment purchase and delivery

  • Mini/Portable: $50,000-$150,000

  • Mobile: $150,000-$400,000

  • Stationary: $300,000-$1,000,000+

Installation Costs: Foundation, utilities, commissioning

  • Mobile: $10,000-$30,000

  • Stationary: $50,000-$200,000+

Annual Operating Expenses:

  • Fuel/Power: $15,000-$50,000 annually

  • Maintenance and service: $10,000-$30,000 annually

  • Operator labor: $60,000-$150,000 annually

  • Wear parts and replacements: $5,000-$20,000 annually

Financial Justification:

For operations producing 300+ m³/day of concrete, owning a batching plant generates savings approximating $825,000 compared to purchasing equivalent volumes of ready-mix concrete. Break-even analysis indicates cost recovery at 6,000-10,000 cubic meters of production, achievable within 3-6 months for typical construction projects.

Making the Final Equipment Selection

Decision Summary

Selecting the optimal continuous concrete batching plant requires systematic evaluation of production requirements, technical specifications, operational flexibility, manufacturer support, and financial considerations. Mobile plants deliver flexibility and rapid deployment, proving cost-effective for temporary projects and multiple-site operations. Stationary plants provide superior production capacity and operational efficiency, justifying their selection for large-scale, long-duration projects.

Regardless of configuration choice, prioritize manufacturers demonstrating commitment to quality, comprehensive after-sales support, and technical expertise. Investments in equipment featuring premium wear components, precise weighing systems, and advanced automation deliver sustained value through extended operational life, reduced maintenance costs, and superior concrete quality.

For detailed technical consultation and custom equipment recommendations tailored to your specific project requirements, professional equipment manufacturers provide expert guidance supporting optimal purchasing decisions. Consulting with experienced technical sales representatives ensures equipment specifications precisely match your operational needs while maximizing long-term return on investment.

Conclusion

The continuous concrete batching plant selection process demands thorough evaluation of technical specifications, operational requirements, financial considerations, and manufacturer support capabilities. By systematically addressing production capacity needs, mixer type selection, automation integration, installation flexibility, and service infrastructure, procurement teams can make confident equipment decisions ensuring long-term operational success and return on investment. Whether selecting mobile solutions for project flexibility or stationary systems for maximum production capacity, alignment of equipment specifications with project requirements enables efficient concrete production meeting quality standards while optimizing operational economics. The investment in comprehensive evaluation during the selection phase yields substantial dividends throughout years of reliable equipment operation and consistent high-quality concrete production.
Share:
We are online 24 hours and ready for your consultation!

We are online 24 hours and ready for your consultation!

Quality castings, welcome to visit!

×

Contact Us

*We respect your privacy. When you submit your contact information, we agree to only contact you in accordance with our Privacy Policy.

×

Inquire

*Name
*Email
Company Name
Tel
*Message
*Code

*We respect your privacy. When you submit your contact information, we agree to only contact you in accordance with our Privacy Policy.
